The PM Procedure |

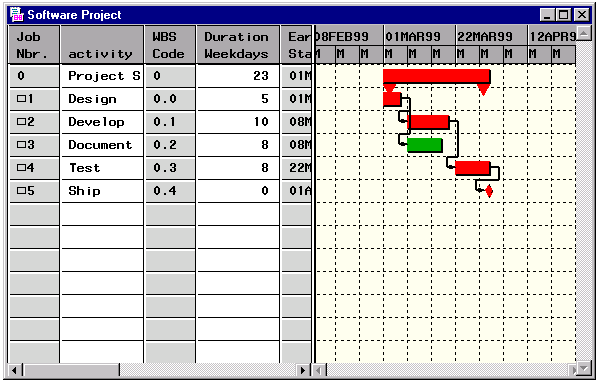

proc pm data=softout1 project=softattr date='1mar99'd interval=weekday projname='Software Project' out=softout1; act actid; succ succid; project pntid; duration duration; id activity; run;Output 6.2.1: Project Schedule
In the current view of the Software Project, you want to add some subtasks to the `Design' and `Develop' tasks. Suppose that these two tasks are broken into two subtasks each, one for `Module 1' and the other for `Module 2'. Further, you want to remove the precedence constraint between the `Design' and `Develop' phases and add constraints between the respective modules. You can accomplish these tasks by making the following editing changes in the PM Window:
Module 1: 5 days Module 2: 3 days
Module 1: 6 days Module 2: 5 days

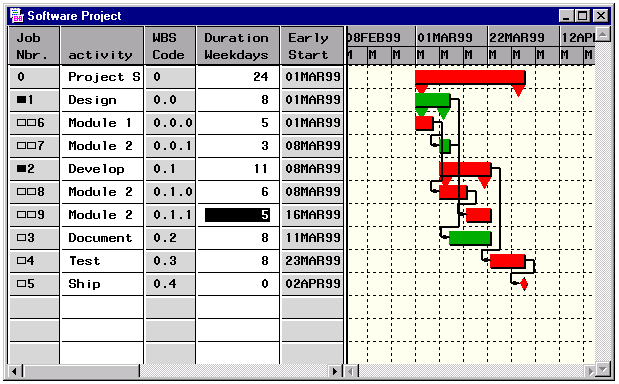

The resulting project schedule is displayed in Output 6.2.2 and saved in the data set SOFTOUT1. Note that the new project duration is 24 days.
Output 6.2.2: Project Schedule
