| The GANTT Procedure |
Because MININTERVAL=WEEK and SCALE=10, PROC GANTT uses (1000/h)% of the screen width to denote one week, where h is the value of HPOS. Note that this choice also causes the chart to become too wide to fit on one page. Thus, PROC GANTT splits the chart into two pages. The first page contains the ID variable as well as the job number while the second page contains only the job number. The chart is split so that the displayed area on each page is approximately equal. The first two PATTERN statements, used for the duration and slack time of noncritical activities, have been changed from the previous two examples. The duration of a noncritical activity is now indicated by a solid blue bar, and the slack time is indicated by a crosshatched blue bar. The SWISS font is used for all Gantt chart text by specifying the FONT= option in the CHART statement. The milestone color is changed to green using the CMILE= option. The resulting Gantt chart is shown in Output 4.6.2.

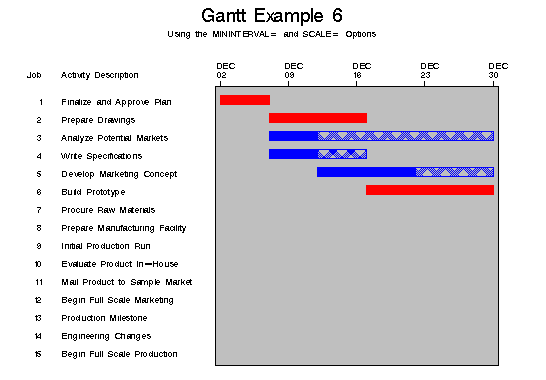

Output 4.6.1: Using the MININTERVAL= and SCALE= Options in Graphics Mode
options ps=60 ls=100;
title f=swiss 'Gantt Example 6';
title2 f=swiss 'Using the MININTERVAL= and SCALE= Options';
data widgaoa;
input task $ 1-12 days tail head;
datalines;
Approve Plan 5 1 2
Drawings 10 2 3
Anal. Market 5 2 4
Write Specs 5 2 3
Prototype 15 3 5
Mkt. Strat. 10 4 6
Materials 10 5 7
Facility 10 5 7
Init. Prod. 10 7 8
Evaluate 10 8 9
Test Market 15 6 9
Changes 5 9 10
Production 0 10 11
Marketing 0 6 12
Dummy 0 8 6
;
data details;
input task $ 1-12 dept $ 15-27 descrpt $ 30-59;
label dept = "Department"
descrpt = "Activity Description";
datalines;
Approve Plan Planning Finalize and Approve Plan
Drawings Engineering Prepare Drawings
Anal. Market Marketing Analyze Potential Markets
Write Specs Engineering Write Specifications
Prototype Engineering Build Prototype
Mkt. Strat. Marketing Develop Marketing Concept
Materials Manufacturing Procure Raw Materials
Facility Manufacturing Prepare Manufacturing Facility
Init. Prod. Manufacturing Initial Production Run
Evaluate Testing Evaluate Product In-House
Test Market Testing Mail Product to Sample Market
Changes Engineering Engineering Changes
Production Manufacturing Begin Full Scale Production
Marketing Marketing Begin Full Scale Marketing
Dummy Production Milestone
;
data widgeta;
merge widgaoa details;
run;
* schedule the project;
proc cpm data=widgeta date='2dec91'd out=save;
tailnode tail;
headnode head;
duration days;
id task dept descrpt;
run;
* sort the schedule by the early start date ;
proc sort;
by e_start;
run;
goptions vpos=42 hpos=80;
* set up required pattern statements;
pattern1 c=blue v=s; /* duration of a noncrit. activity */
pattern2 c=blue v=x5; /* slack time for a noncrit. act. */
pattern3 c=red v=s; /* duration of a critical activity */
* plot the schedule;
proc gantt;
chart / mininterval=week scale=10
dur=days cmile=green
ref='1dec91'd to '1feb92'd by month
font=swiss
nolegend;
id descrpt;
run;

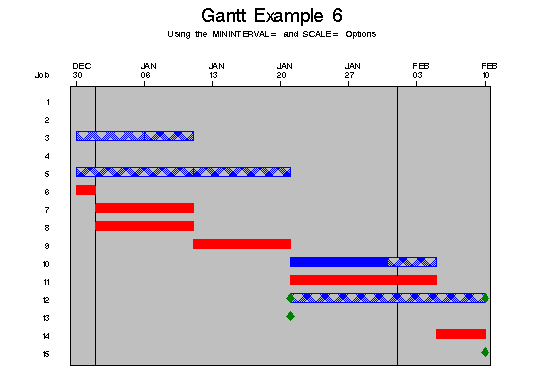

Output 4.6.2: Using the MININTERVAL= and SCALE= Options in Graphics Mode
|
|
|
